GREE                                                                        GMV5E DC INVERTER VRF UNITS SERVICE MANUAL
    73
Step 8: Perform step 3 again.
Step 9: Perform step 5 and step 6 again. Record the weight before perfusion m3 and weight after
perfusion m4.
Step 10: If there is no sufficient refrigerant and the calculated quantity of refrigerant is not fulfilled for
the system, record the current total perfusion quantity.
m=(m1-m2) +(m3-m4) +…+(mn-1-mn)
Quantity of refrigerant to be perfused during running m`=M-m
M is the required total quantity
If the pre-perfusion quantity (m) reaches the required total quantity for the system, turn off the valve
of the refrigerant tank immediately to finish perfusing and proceed with step 11.
Step 11: Remove the pressure gauge.
9.2.2 Refrigerant Perfusion During Running
Step 1: Turn off the valve of the refrigerant tank and reconnect the pressure gauge pipe. Disconnect
the low pressure gauge pipe from the detection valve opening of the gas liquid and connect it to the low

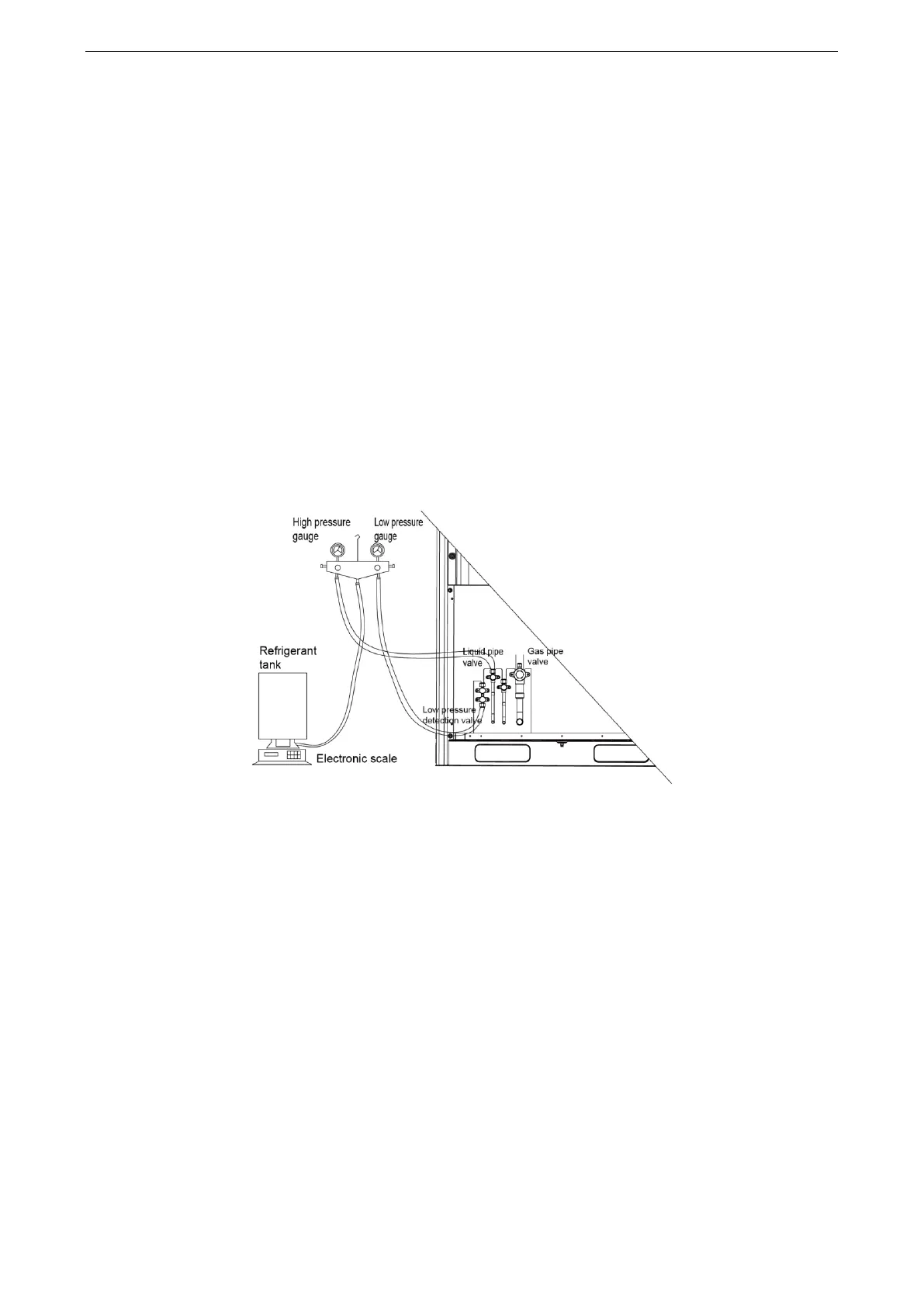

pressure detection valve, as shown in the following figure.

Step 2: Turn on the valves for the liquid and gas pipes of each module completely. For the modular
unit, the oil-equalizing valve of each module also needs to be turned on.
Step 3: Make the system to run in commissioning mode via the commissioning software or the main
board of the ODU. (For details, see the description on commissioning.)
Step  4:  When  the  commissioning  step  goes  to  refrigerant  perfusion,  turn  on  the  valve  of  the
refrigerant tank and perfuse the remaining quantity (m`).
Step  5:  After  all  refrigerant  is  perfused,  turn  off  valve  of  the  refrigerant  tank  and  wait  till
commissioning is automatically is completed for the system.
Step 6: Remove the pressure gauge to finish refrigerant perfusion.
