HD-973P Series Multi-Level Parking Lift 39 P/N 5900076 — Rev. B3 — January 2024

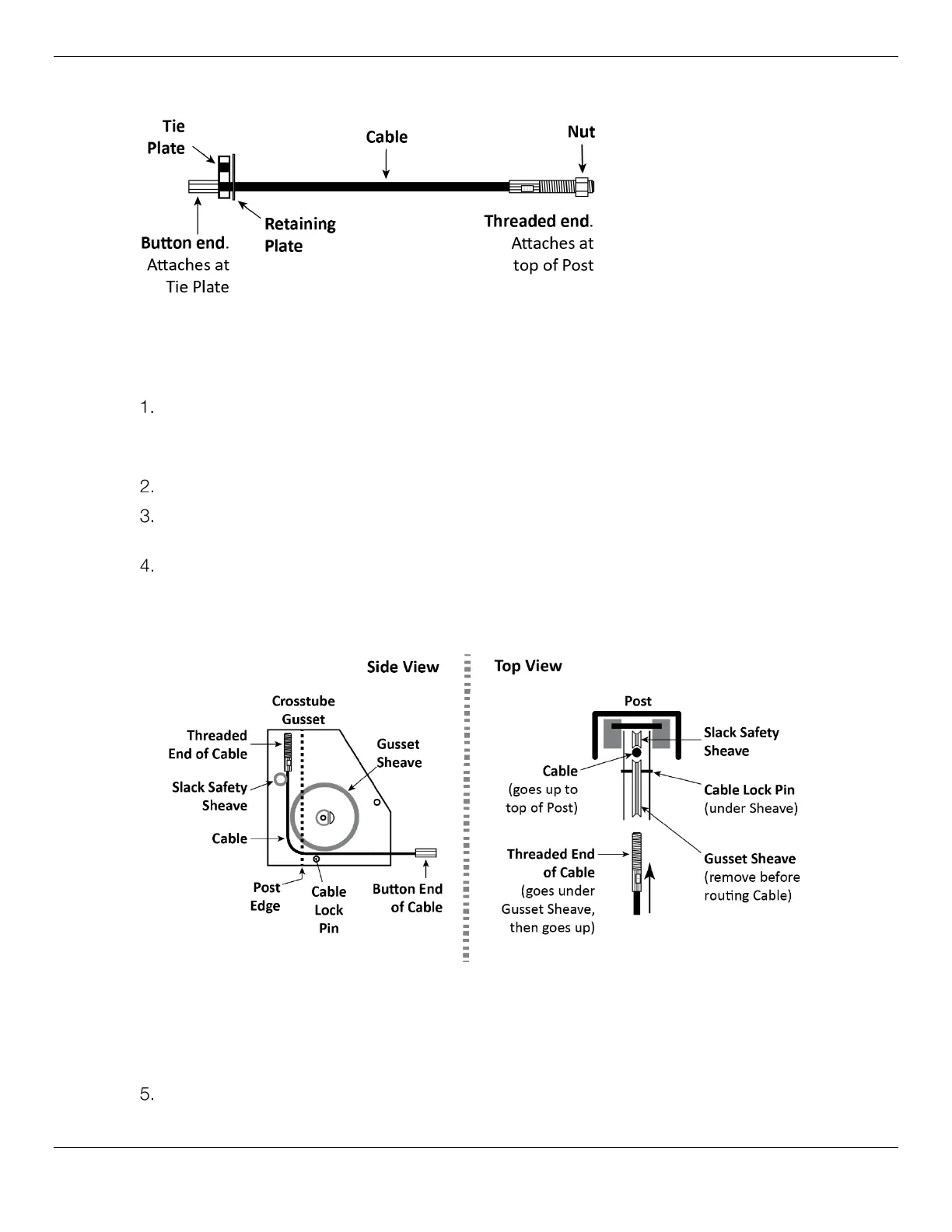

The following drawing shows the Tie Plate and Retaining Plate.
Before routing the Cables, extend the Hydraulic Cylinder’s Piston and Retaining Plate. See the
previous procedure for more information.
To route Lifting Cables A and C:
Starting with Lifting Cable A, move the entire thing to just under the Medium Window it goes
through, near the bottom of Post A.
Check the label to make sure you have the correct Lifting Cable.
Remove the Nut and Washer from the Threaded End (but keep it nearby, you will need it soon).
Route the Threaded End of Lifting Cable A into its Medium Window on the Crosstube, push it
towards Post A, and then pull the Threaded End out of the Crosstube at the bottom of the Gusset.
Route the Threaded End of Lifting Cable A under where the Gusset Sheave will go when it is
reinstalled, then route it up towards the top of the Post past the top of the Crosstube Gusset.
When you start routing the Cable up, it must be between the Gusset Sheave and Slack Safety
Sheave, as shown below.
Important: When routing a Lifting Cable in its Post, it must go under where the
Gusset Sheave will go when the Gusset Sheave is reinstalled and then, when it
heads up towards the top of the Post, it must be between where the Gusset
Sheave will go and where the Slack Safety Sheave already is. If the Cable is not in
this exact location, the Slack Safeties will not work correctly later.
With the Lifting Cable in place, reinstall the Gusset Sheave and the Cable Lock Pin in Post A.
