Points to Bear in Mind at the System Design SiE33-102
8 General Information
2.3 Striking a Balance between System Installation and General Construction

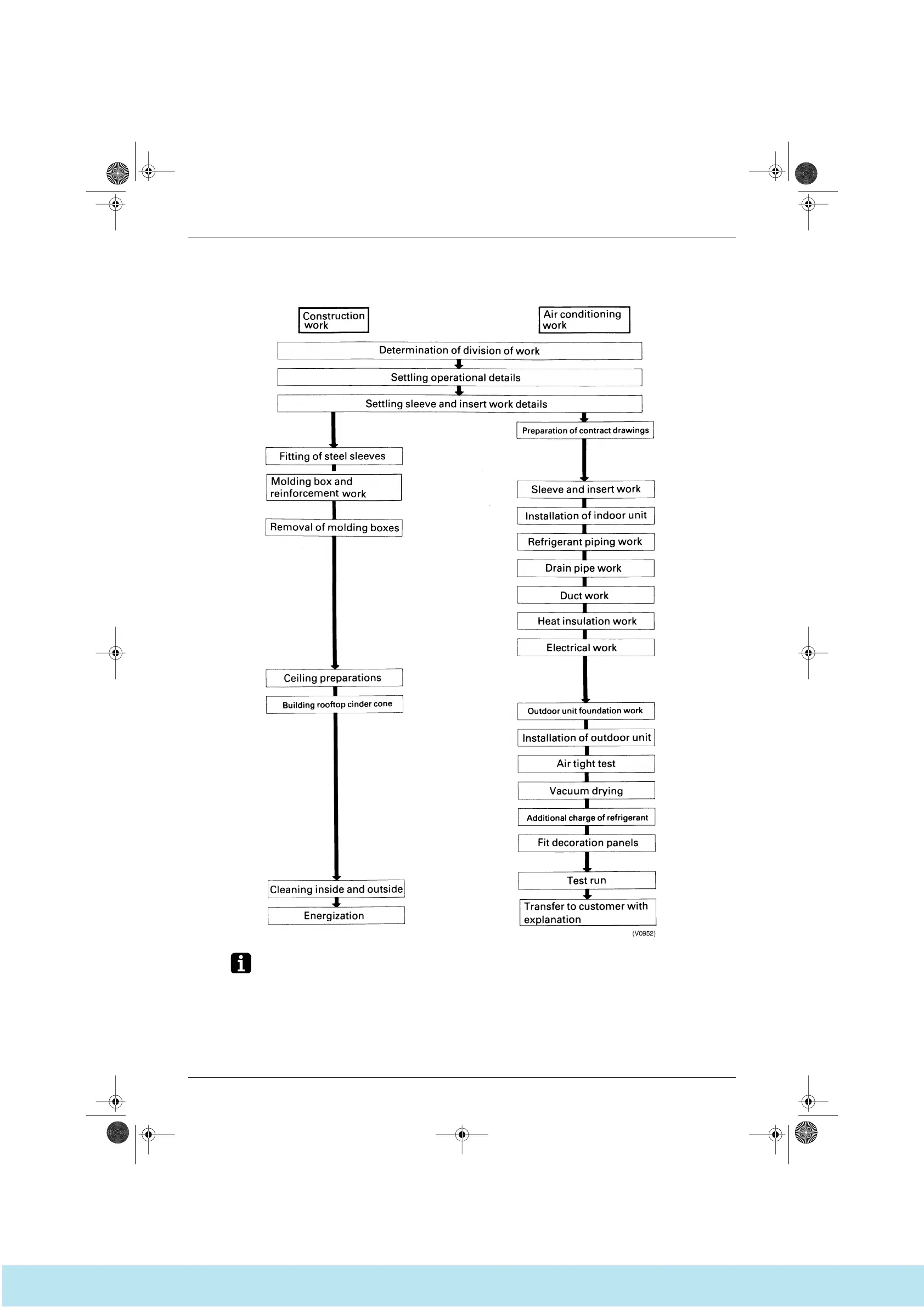

Work (Comprehensive Flow Chart)
Note: 1. The division of the work should be thoroughly clarified. (This applies particularly to work relating to the
connection of control wiring, fitting of remote control and central control panel, boundary work on areas
such as connection of drain piping and humidification supply piping, inspection and foundation)
2. Keep a constant check on the progress of the construction work to avoid deviations from the air
conditioning work schedule.
3. For sleeve and insert work the positions of ceiling girders should be confirmed and sleeve and insert
requirement, hole diameters, positioning and numbers decided. This is particularly important in the case
of sleeves for drain piping.
