28 Instructions for Assembly and Use – Standard Configuration
CB 160 Climbing Formwork
B1 Work on the construction site
Mounting of the finishing
platform CB 160
Preparation
1. Remove tacked on planking parts
from both sides of the platform
beam.
2. Attach 4-sling lifting gear to the four
bolts and move finishing platform to
the assembly area.

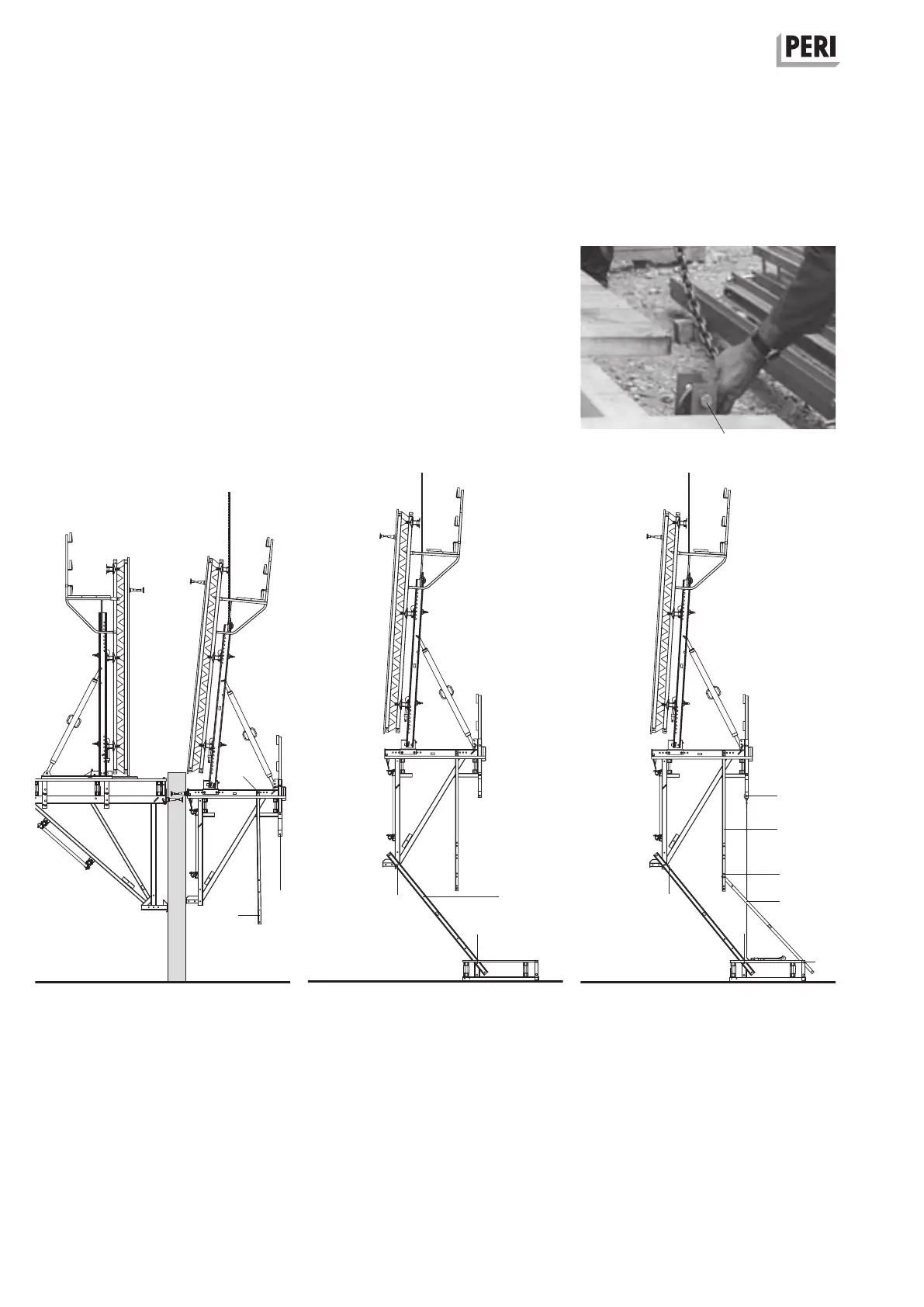

(Fig. B1.23)
Fig. B1.24
Connecting to the brackets
Connections are done using Bolts
M16 x 130 ISO 4014-8.8 and self-securing
nuts (9.6) (supplied with components).
Initially, only loosely tighten bolts for
the articulated connections.
1. Connect Guardrail Post 200 (9.3) to
the bracket and tighten bolts (9.6).
Bolt on top part of the wind bracing
(7.2), see B1 Assembly of wind
bracing.
2. Attach platform unit to strongback
and lift out of the anchoring. Do not
exceed crane capacity, see B4.
(Fig. B1.24)
3. Pivot platform unit over the finishing
platform.
4. Bolt Platform Post 225 (9.1) to post
extension 180 (9.2) and fix to the
bracket and finishing platform at an
angle with bolt (9.6). (Fig. B1.25)
Depending on the concreting height,
use top or bottom hole. (Fig. B1.26)
5. Fix the Guardrail Post 190 (9.4) or
Guardrail Post 370 (9.5) to Guardrail
Post 200 (9.3) at an angle using bolt
(9.6). Depending on the concreting
height, use top or bottom hole.
(Fig. B1.26a – d) Attach wind bracing
(7), see B1.
6. Fix the toe board at the lower end.
(Fig. B1.26)
Fig. B1.25
9.6
9.3
7. 2
9.6
9.6
9.1
9.2
9.6
9.6
9.4
9.5
9.6
9.6
9.3
7
Fig. B1.26
9.6
Fig. B1.23
